委外前置时间¶
在 Odoo 中,交付周期用于预测完成某项操作所需的时间。例如,可以为购买的产品设置 交货所需时间 ,规定产品供应商将产品交付给购买公司通常需要的天数。
具体就委外产品而言,可以根据委外服务商生产产品所需的时间来配置交付周期。这样,承包公司就能更好地预测委外产品的交货日期。
某些委外产品要求承包公司向委外服务商提供制造组件。在这种情况下,除了交货所需时间外,还可以使用 制造所需时间 来生成委外服务商必须收到所需组件的日期,以便制造产品并按时交货。
重要
与 Odoo 中的所有交付周期一样,委外产品的交付周期也只是一个估计值,根据 预计 的行动时间计算而来。
不可预见的情况可能会影响这些操作的完成,这意味着前置时间不应被视为保证。
配置¶
当使用 按订单向委外服务商补货 路线时,公司负责向委外服务商提供必要的组件。因此,在收到组件之前,委外服务商不能开始生产。
This means that, in addition to the amount of time it takes the subcontractor to manufacture and deliver the product, the date they receive the components must also be considered.
通过为产品的委外服务商指定交货所需时间,并在产品的物料清单(BoM)上指定制造所需时间,产品组件的 委外服务商补货 订单就会显示委外服务商必须收到组件的截止日期。
产品交付周期¶
要为产品的委外服务商设置发货所需时间,请导航至
,然后选择委外产品。Then, select the Purchase tab on the product’s page. If the subcontractor has not already been added as a vendor, do so now by clicking Add a line, and selecting the subcontractor in the Vendor field.

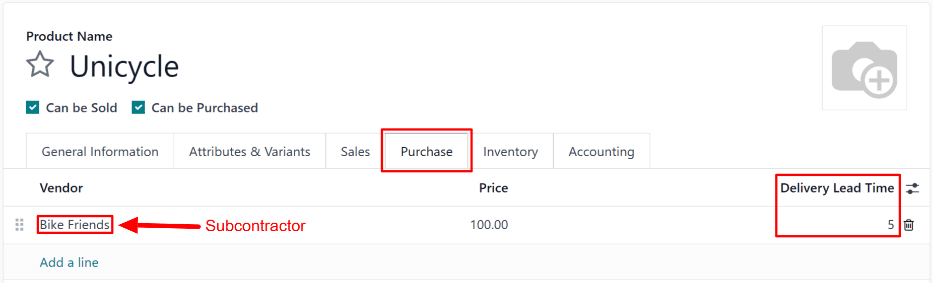

添加委外服务商后,在 发货所需时间 栏中输入生产和交付产品所需的天数。

产品制造所需时间¶
接下来,通过点击产品页面顶部的 物料清单 智能按钮导航到产品的 BoM 。然后,从列表中选择一个 BoM 。

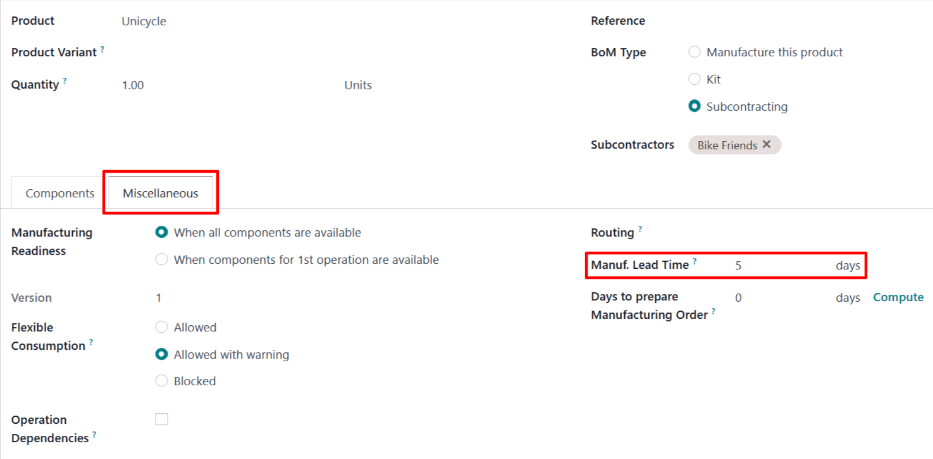

在 BoM 中,选择 杂项 选项卡。在 制造所需时间 字段中,输入与 BoM 产品的 交货所需时间 字段中相同的天数。

虽然委外服务商实际上并没有使用所有这些天数进行生产,但在每个字段中设置相同的天数会告诉 Odoo,委外服务商必须在产品交付周期开始前收到组件,并开始生产。这样委外服务商就有足够的时间生产和交付产品。
委外补货工作流¶
通过导航至 新建 ,为产品创建询价单(RfQ)。
,并点击在 供应商 字段中指定委外服务商。然后,通过点击 添加产品 ,在 产品 列中选择产品,并在 数量 列中指定数量,在 产品 选项卡中添加产品。
在 预期到达日期 字段中,输入一个足够的时间,以便分包商能够接收组件、制造产品并将其交付回分包公司。
重要
当产品被添加到 RfQ 时,预期到达日期 字段会自动填充为今天的日期加上产品的交货前置时间。然而,这 不 考虑将组件运送到分包商所需的时间。
在使用 [按订单向委外服务商补货] 路线购买委外产品时,有必要调整该日期,以考虑到部件运往委外服务商所需的额外时间。
由于生产要等到收到部件后才开始,如果不更改日期,成品就会在 RfQ 所列日期 之后 到达。
Next, click Confirm Order to turn the RfQ into a PO. Doing so causes a Resupply smart button to appear at the top of the page.
点击 补货 智能按钮,打开委外服务商补货订单,这是为向委外服务商发送组件而创建的订单。
委外服务商补货订单上的 截止日期 字段显示委外服务商接收组件的截止日期,以便他们有足够的时间在预计到达日期前生产和交付成品。
The Scheduled Date field should display the latest date on which components can be shipped, while still arriving to the subcontractor by the Deadline. However, by default, the date displayed is the same as the date in the Deadline field, and must be updated to take into account the time required for shipping.
点击 已安排日期 字段,打开日历弹出窗口,从中选择日期。选择一个可以在委外服务商补货订单上的 截止日期 之前交付组件的日期。
After the components are shipped, click the Validate button at the top of the order to confirm they have been sent to the subcontractor.
Once the subcontractor receives the components, they begin manufacturing the component, before delivering it to the contracting company.
Example
Bike retailer Mike’s Bikes works with a subcontractor — Bike Friends — to produce units of their Unicycle product.
Mike’s Bikes must supply Bike Friends with the necessary components for manufacturing the unicycles.
On average, Bike Friends takes three days to manufacture each unicycle, plus an additional two days to deliver it to Mike’s Bikes.
As a result, Mike’s Bikes sets a delivery lead time of five days for unicycles manufactured by Bike Friends: three days for manufacturing, plus two days for delivery.
On the unicycle’s BoM, they enter a manufacturing lead time of five days, as well, to remind themselves of the date that components must be delivered to the subcontractor.
They confirm a PO for one unicycle, with an expected arrival date of May 30th.
向委外服务商运送部件的委外服务商补货订单显示*截止日期*为 5 月 25 日。委外服务商必须在此日期之前收到组件,以便有足够的时间制造独轮车,并在 5 月 30 日之前交货。

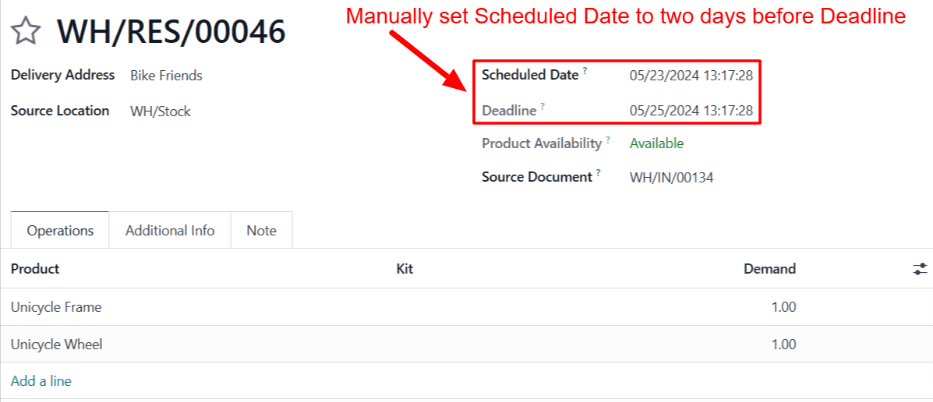

Mike’s Bikes 需要两天时间来交付组件,因此他们将委外服务商补货订单上的*计划日期*字段更新为 5 月 23 日,即截止日期前两天。

Mike’s Bikes ships the components to Bike Friends on the scheduled date of May 23rd, and they arrive on the deadline of May 25th. This gives Bike Friends enough time to manufacture the unicycle, and ship it back to Mike’s Bikes by the expected arrival date of May 30th.
